The Clayton Valley Lithium project is located adjacent to Albemarle’s Silver Peak mine and Pure Energy Minerals’ lithium brine operation. Image courtesy of Cypress Development Corp.

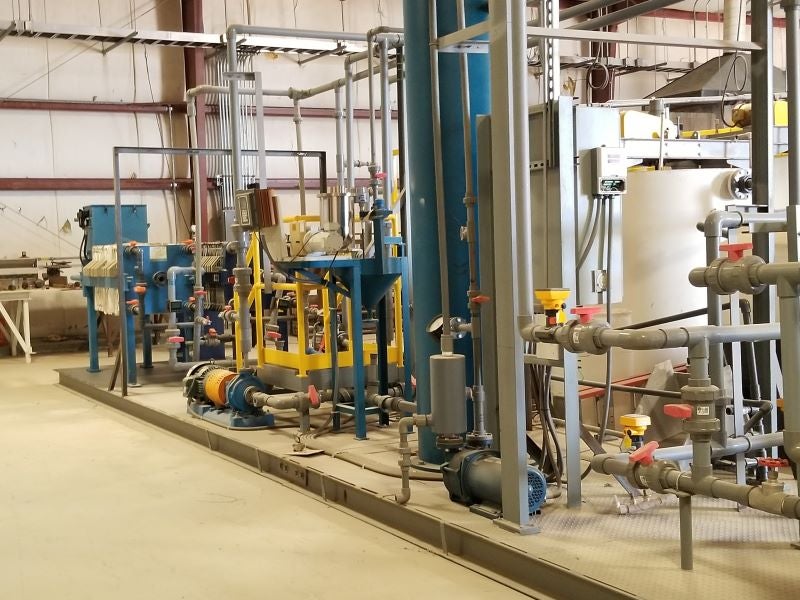

Cypress Development began the development of a pilot processing plant for the lithium project in March 2021. Image courtesy of Cypress Development Corp.
The pilot plant will initially use chloride-based leaching. Image courtesy of Cypress Development Corp.

The Angel Island lithium project, previously known as the Clayton Valley lithium project, is an open-pit mining development in Nevada, US.

Canada-based lithium exploration company Century Lithium (formerly Cypress Development) is developing the project.

A pre-feasibility study (PFS) for the lithium project was completed in August 2020, which was updated in March 2021. A new feasibility study for the project was completed in April 2024.

An updated feasibility study was completed in March 2026. The new study highlighted a project life of 62 years, with an initial capital cost of $997m for the initial development phase, followed by an expansion of the process facilities and infrastructure established in phase one, with a capital cost of $660m.

In September 2026, Century Lithium submitted the Mine Plan of Operations (PoO) and Nevada Reclamation Permit Application for the project to the US Bureau of Land Management (BLM).

The PoO represents the proposed action for the project and will form the basis for the BLM’s environmental analysis under the National Environmental Policy Act (NEPA). The PoO was deemed complete by BLM in November, opening the next step for the project to move into its environmental review phase. The BLM’s is anticipated to issue its Record of Decision for the project in February 2028.

Construction activities are proposed to commence in the first half (H1) of 2029, with initial production scheduled to commence in H1 2030.

Angel Island project location

The Angel Island lithium project is located in central Esmeralda County, immediately east of Albemarle’s Silver Peak mine, which has been in operation since 1966 and is the only lithium-producing operation in North America.

It also adjoins the 23,300-acre Clayton Valley lithium brine project being developed by Canadian mineral exploration firm Pure Energy Minerals.

The project area encompasses 129 unpatented placer mining claims and 212 unpatented lode mining claims spanning approximately 5,430 acres.

Geology and mineralisation at Angel Island

The project deposits are hosted by a closed basin located near the south-western margin of a vast physiographic region in western Nevada, known as the Basin and Range province. The uplifted basement rocks of Angel Island, comprising metavolcanic and clastic rocks, as well as colluvium, dominate the western part of the project area.

The southern and eastern portions of the project area, on the other hand, mainly comprise uplifted, lacustrine sedimentary units of the Esmeralda formation that feature fine-grained sedimentary and tuffaceous units.

The mineralisation at the Angel Island lithium project is found as elevated lithium concentrations above 600 parts per million (ppm) in the Esmeralda formation. It extends up to 142m below the surface.

The silica-rich, lithium-bearing sediments in the project area contain moderately calcareous, interbedded tuffaceous mudstones, siltstones, and claystones. The primary mineralised zone is hosted by a claystone unit that comprises the oxidised and unaltered claystone zones.

Angel Island lithium project reserves

The proven and probable mineral reserves at the Angel Island lithium project were estimated to be 287.6 million tonnes (mt), grading 1,149ppm lithium with 1.75mt in contained lithium carbonate equivalent (LCE) as of April 2024.

Mining method at Angel Island

The project will utilise conventional open-pit mining methods to extract lithium using dozers with a ripper shank, trucks, and shovels. The consolidated sedimentary layers allow for free digging, and pre-stripping and excavation will proceed without prior blasting.

Following extraction, the fragmented clay strata will be arranged into in-pit windrows, allowing the loose material to undergo atmospheric drying directly within the void prior to haulage.

Mining operations will commence in the south-west, where mineralised clay seams outcrop at the surface, before advancing north-eastwards where higher-grade strata dip beneath low-grade material and waste overburden.

Bench height and width were set at 5m and 6m, respectively, based on the operating equipment’s reach and the minimum required road width. Mining equipment will comprise CAT 6020B or equivalent hydraulic shovels and will be transported by CAT 777 haul trucks and supported by an auxiliary fleet.

Overall mine development incorporates six distinct phases engineered to sustain target processing feed rates of 7,500 tonnes per day (tpd) across the first four years, subsequently expanding to 15,000tpd for the remainder of the project life.

Mineral processing at Angel Island lithium project

The run-of-mine (ROM) ore will undergo crushing in a double roll crusher, and an apron feeder will transfer the crushed ore to the storage stockpile.

The crushed claystone will be mixed with process water at 33% solids by weight in an attrition scrubber. The underflow will advance to the leach circuit, while the coarse oversize will be directed to the tailings stream.

Leaching will take place in two insulated, rubber-lined tanks, with impurity precipitation carried out in a 10m²-diameter tank fitted with agitators. The slurry will then pass through six membrane plate and frame filters. The recovered direct lithium extractant (DLE) solution will retain an estimated 84% lithium recovery at this stage.

The clarified DLE solution will pass through a 0.5-micron ultrafiltration system comprising five modules. The filtered solution will be pumped through rubber-lined centrifugal pumps before DLE.

Lithium extraction will be carried out in a simulated moving bed system comprising two parallel trains of columns. The DLE circuit will process a feed containing 250ppm to 350ppm lithium and will be designed for more than 92% annual operating availability. Reverse osmosis (RO) permeate water will be used to strip lithium from the adsorbent.

The concentrated lithium eluate will undergo final purification in an ultrafiltration unit followed by nanofiltration before lithium carbonate precipitation.

Lithium carbonate will be precipitated in a Nutsche filter, with the resulting solids to be washed and transferred to an electrically heated rotary dryer. The dried lithium carbonate will be stored before being packaged.

Site infrastructure

The project site is accessible from Tonopah, Nevada, by a 35.4km-long stretch of the US Highway 95 and a 30km-long Silver Peak gravel road.

A permanent power transmission line and substation is located approximately five miles (8km) from the project site. Power will be delivered to the site through an upgraded 90kV transmission line connected to a permanent on-site substation, which will distribute electricity to the project facilities. Backup power will be provided by a 1MW modular standby power plant.

All operational water will be supplied to the plant facilities via a pipeline running from a well field situated in Clayton Valley. The line will be buried beneath the frost line and will be constructed from high-density polyethylene (HDPE) piping.

Contractors involved

American minerals consultancy Continental Metallurgical Services (CMS) and Global Resource Engineering (GRE) jointly prepared the PFS for the project. NORAM Engineering and Constructors were engaged to develop the process flowsheet to efficiently concentrate the lithium.

US-based lithium extraction company Lilac Solutions was selected to test its proprietary lithium IX resin for ion exchange testing.

Century Lithium signed a share purchase and licence agreement with Chemionex, a hydrometallurgical process development company based in Canada, in July 2021 to license its proprietary technology for the DLE section of the project’s processing plant.

The 2024 feasibility study was prepared by Wood Group USA and GRE while the 2026 updated feasibility study was prepared by Mineral Property Development (MPDI), GRE and SRK Incorporated (SRK).
